Virar Alibaug Multimodal Corridor: Route & Status (2026) ​
Virar Alibaug Multimodal Corridor

Project Profiles

Virar Alibaug Multimodal Corridor

Updated on Feb 27, 2026, 01:12 PM IST
Written by Siddhi Jain

Table of Contents

  • Loading contents...

Project at a Glance

Project Name

Virar Alibaug Multimodal Corridor

Alternate Name

VAMMC or MMC

Project Sector

Infrastructure project

Project Status

Under construction

Project Developer

Maharashtra State Road Development Corporation (MSRDC)

Project Cost

INR 63,618 crore (approximately USD 7.59 billion)

Expressway Length

126 km

Lanes

8-14 lanes

Speed Limit

120 km/hr

Completion Date

2030

Right-of-way

99 meters

Starting Point

Navghar (near Virar)

Ending Point

Chowk (near Alibaug)

Project Overview

The Virar Alibaug Multi-Modal Corridor (VAMMC) is an 8-14 lane access-controlled expressway connecting Virar & Alibaug. Developed by the Maharashtra State Road Development Corporation (MSRDC), the expressway is designed to operate at 120 km/hr.

It is a 126 km route that covers three districts: Raigad, Thane, and Palghar. Expected to become fully operational by 2030, it will be developed in two phases. Phase I is 96.41 km long, connecting Navghar to Balavali, and Phase II is a 29.9 km-long corridor from Balavali to Alibaug.

The project is crucial for the Mumbai Metropolitan Region (MMR), especially Package 6, as it connects the Delhi-Mumbai Expressway's JNPT Spur with the Mumbai-Pune Expressway. As the name suggests, “ Multi-Modal Corridor”, the expressway comprises different modes of transportation, including Road, Rail, & Metro to create smooth travel.

As one of the most ambitious projects in the region, the expressway will decongest the Mumbai Metropolitan Region (MMR), improve logistics, and boost the local economy.

Project Background

To provide smooth travel to major MMR areas, the Virar Alibaug Multi-Modal Corridor (VAMC) project was proposed during the World Bank MUTP implementation support mission from 23 July to 6 August 2008. It obtained consultancy services for the Feasibility Studies of the Multimodal Corridor.

It was proposed in the TRANSFORM Comprehensive Transportation Study (CTS) for the Mumbai Metropolitan Region, prepared by the Government of Maharashtra and World Bank Financial Assistance. It was implemented by the MMRDA under the Mumbai Urban Transport Project (MUTP).

In July 2008, the reports analysed the corridor as one of the major recommendations for meeting MMR's travel demand through 2031. As part of the MMC, seven growth centers are being established in the MMR region, namely Virar, Bhiwandi, Kalyan, Dombivali, Panvel, Uran, and Taloja MIDCs.

Mumbai Metropolitan Region Development Authority (MMRDA) completed its Techno-Economic and Financial Feasibility Study for the project in March 2012 by appointing Consultants M/s Louis Berger Group, Inc. (LBG). The project’s construction duties were transferred to the Maharashtra State Road Development Corporation (MSRDC) in September 2020.

In 2024, bids were invited for the VAMMC under the Engineering, Procurement, and Construction (EPC) Model, along with the Pune Outer Ring Road and the Jalna-Nanded Expressway. However, the bids were significantly higher than MSRDC's estimates, and hence negotiations with the contractors failed. Thus, the project will now be constructed on a Build-Operate-Transfer (BOT) model.

Virar Alibaug Multimodal Corridor Land Acquisition

The project’s alignment passes through and connects three districts: Raigad, Thane, and Palghar. The land acquisition process requires approximately 1,347 hectares for Phase I development. Out of it, 61.29 hectares of land will be acquired in Palghar, 520.92 hectares in Thane, and about 765.01 hectares of land will be acquired in Raigad.

As of early 2026, nearly 80-90% of the land for phase I has been acquired. This kick-starts the preliminary work on the first 25 km (Virar-Bhiwandi) stretch. MSRDC's targets to hand over at least 70% of the total Phase 1 land parcels (out of 1,347 hectares) to the future BOT contractor by Mid 2026.

Virar Alibaug Multimodal Corridor Current Status & Completion Date

As of February 2026, the Multi-Modal Corridor began preliminary work, including site clearing and construction of access roads, on the first 25 km section from Virar to Bhiwandi. Fresh tenders for Phase I under the BOT model are expected to be released by April 2026.

Furthermore, the coordination with NHAI and CIDCO is ongoing for the integration of metro and freight corridors.

Phase I of this access-controlled expressway is expected to be completed by 2027, with full completion and operation expected by 2030.

40+ reviews

Find the Latest Road Infrastructure Projects In India

Gain exclusive access to our industry-leading database of infrastructure opportunities with detailed project timelines and stakeholder information.

​Collect Your Free Leads Here!

No credit cardUp-to-date coverage

Joined by 750+ industry professionals last month

Virar Alibaug Multimodal Corridor Project Cost

The total estimated cost for the construction of the Virar Alibaug Multimodal Corridor is INR 63,618 crore (approximately USD 7.59 billion).

HUDCO will provide a loan for the ambitious Virar-Alibaug Multi-Modal Corridor project. The Government of Maharashtra will serve as the guarantor for the loan from HUDCO.

INR 37,013 crores have been earmarked for this project, including INR 22,250 crores for land acquisition and INR 14,763 crores for interest.

Virar Alibaug Multimodal Corridor Map

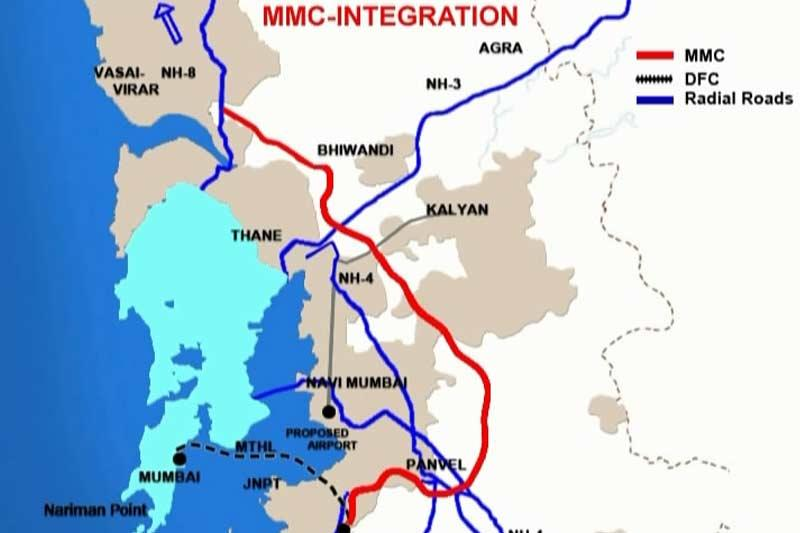

Virar Alibaug Mumtimodal Corridor Map

Virar Alibaug Multimodal Corridor Route

The Virar Alibaug Multimodal Corridor starts from Navghar (near Virar) and terminates at Chowk (near Alibaug). It covers a 126 km route, linking key districts including Palghar, Thane, Mumbai Suburban, and Raigad.

The route passes through some of the major national highways, including NH8, Bhiwandi Bypass, NH3, NH4, NH4B, Mumbai Pune Expressway, and NH17. This access-controlled expressway improves connectivity to JNPT, the Navi Mumbai International Airport, the Mumbai Trans Harbour Link (MTHL) Project, and the Dedicated Freight Corridor (DFC).

Virar Alibaug Multimodal Corridor Villages List

Districts

Villages

Palghar

Virar, Navghar, Kaman, Sasunavghar, Gokhivare

Thane

Bhiwandi, Kalyan, Dombivli, Shilphata, Taloja

Mumbai Suburban Region

Ghodbunder, Mankoli, Diva

Raigad District

Chirner, Pen, Chowk, and Alibaug


Virar Alibaug Multimodal Corridor Phases

The VAMMC, an 8-14-lane access-controlled expressway, is to be built in two phases, with the first covering a major section. The phase details are discussed below:

Phase I

Phase I is a 96.41 km long stretch starting from Navghar (near Virar in Palghar) and terminating at Balavali (near Pen in Raigad). It requires 1,347 hectares for land acquisition, at a cost of approximately INR 22,250 crores.

Now, to be built on the BOT model, rather than the EPC model, the route connects NH-48 at Bhiwandi, Kalyan, Panvel, and JNPT. It links northern Mumbai Metropolitan Region (MMR) hubs to major ports, like Navi Mumbai International Airport (NMIA).

Phase II

Phase II is a small stretch of approximately 29.9 km starting from Balavali to Alibaug. It links with NH-17, crossing through key areas of Pen & Chowk to provide the final coastal access. It comprises multimodal features, including integration with Metro Line 14, aiming for full completion by 2030.

Project Timeline

Year

Event

2030

Expected completion of the project

2027

Phase I completion (expected)

Early 2026

Groundwork begins on the first 25 km Virar-Bhiwandi section

September 2025

Full project approved & land acquisition work gained momentum

17 June 2025

BOT Model approved

May 2024

Financial bids opened for the VAMMC project

September 2022

MSRDC applied for forest clearance for the Naghar – Chirner section

June 2021

MSRDC received environment clearance for an 18 km section from Chirner to Balvali

September 2020

MSRDC was handed the construction responsibility

40+ reviews

Find the Latest Road Infrastructure Projects In India

Gain exclusive access to our industry-leading database of infrastructure project opportunities with detailed project timelines and stakeholder information.

​Collect Your Free Leads Here!

No credit cardUp-to-date coverage

Joined by 750+ industry professionals last month

Project Scope

The following is the project scope of the VAMMC:

  • Right-of-Way (RoW): The MMC comprises a 99 m right-of-way, integrating highways, service lanes, parking lanes, a pedestrian footpath, a metro center, utilities, bus rapid transit, and non-motorized traffic lanes.

  • Integration: The corridor crosses through tunnels, bridges, and interchanges connecting with key national highways, including NH3, NH4, Mumbai-Pune Expressway, MTHL, and NH17.

  • Speed Limit: The 126 km MMC corridor is designed to operate at a speed of 120 km/hr.

Benefits

The following are the benefits generated from the project:

  • Create employment opportunities: The MMC creates employment opportunities in seven growth centers in MMR, including Virar, Bhiwandi, Kalyan, Dombivli, Panvel, Taloja, and Uran.

  • Growth in residential & commercial areas: The corridor will support residential and commercial development in areas such as Panvel, Uran, Kalyan, Taloja, Kalyan-Shil Road, Virar, Vasai, and Pen, along with other infrastructure projects.

  • Seamless connectivity: The corridor provides smooth connectivity to the NMIA, JNPT port, MTHL/Atal Setu, Mumbai-Pune Expressway, and northern MMR hubs (Bhiwandi, Panvel).

  • Ensures multiple travel modes: The corridor integrates with Metro Line 14, BRT, and buses, providing multiple options and promoting public transport.

  • Boost real estate: Upon completion of the project, the corridor will boost real estate in the region.

  • Reduce logistics costs: The expressway improves freight movement to JNPT, reducing logistics costs by 20-30%.

Conclusion

The Virar-Alibaug Multimodal Corridor is an 8-to 14-lane access-controlled expressway developed by the MSRDC. Initially planned by the MMRDA, the expressway will connect Virar to Alibaug in just 90 minutes upon its completion.

Running at a speed of 120 km/hr, the corridor integrates with national highways, metro, BRT, & Utilities, and aims to boost the economies of Bhiwandi, Panvel, and Alibaug, generate millions of jobs, and promote sustainable transport.

As of 2026, the project’s land acquisition work is 90% done. The groundwork for the first section between Virar and Bhiwandi has started. It's worth noting that the shift to BOT accelerated private funding despite tender hurdles.
